Hello All,
I need to schedule the resources allocation as part of an integration project where the workload is the same across the defined period (eg: engineer is working 55% of his time between January and April). We only calculate resource allocation on a monthly period and man days per month.

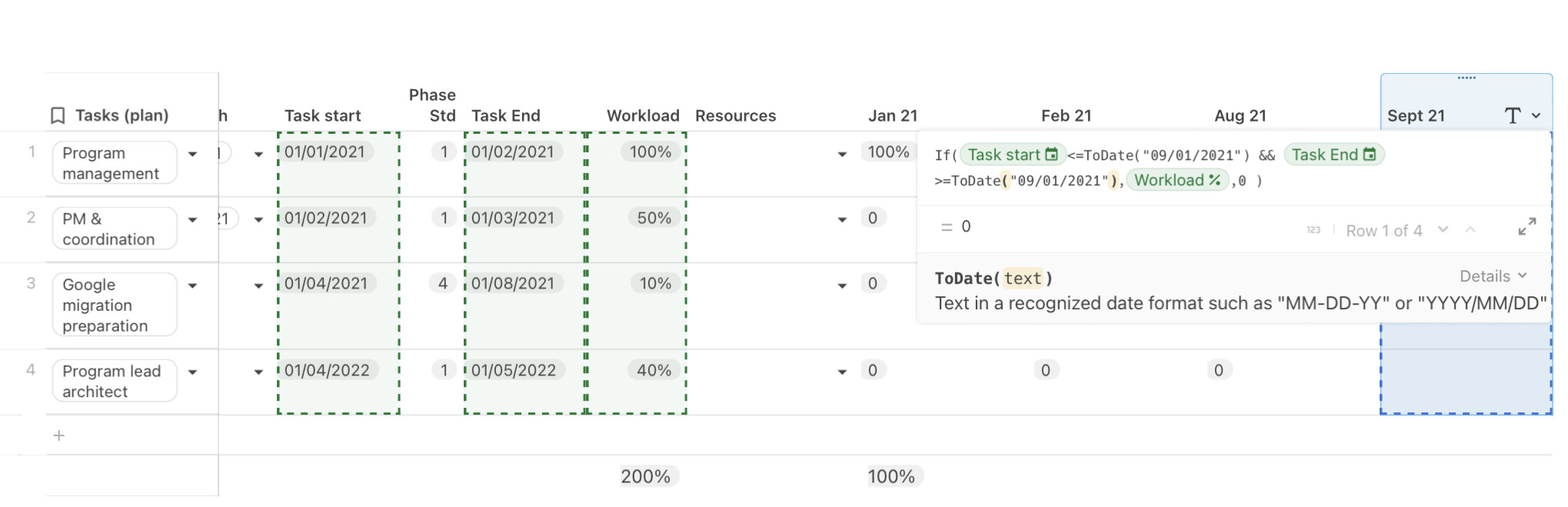

I created a table where I choose the task that gives me the utilisation and I pick the starting month which based on a predefined duration (in month) will give me the end date.
.I obviously allocate several tasks for the project.
So I have the following value for now:
- task (manual)
- starting date (manual)
- Duration (predefined - in months - task attribute)

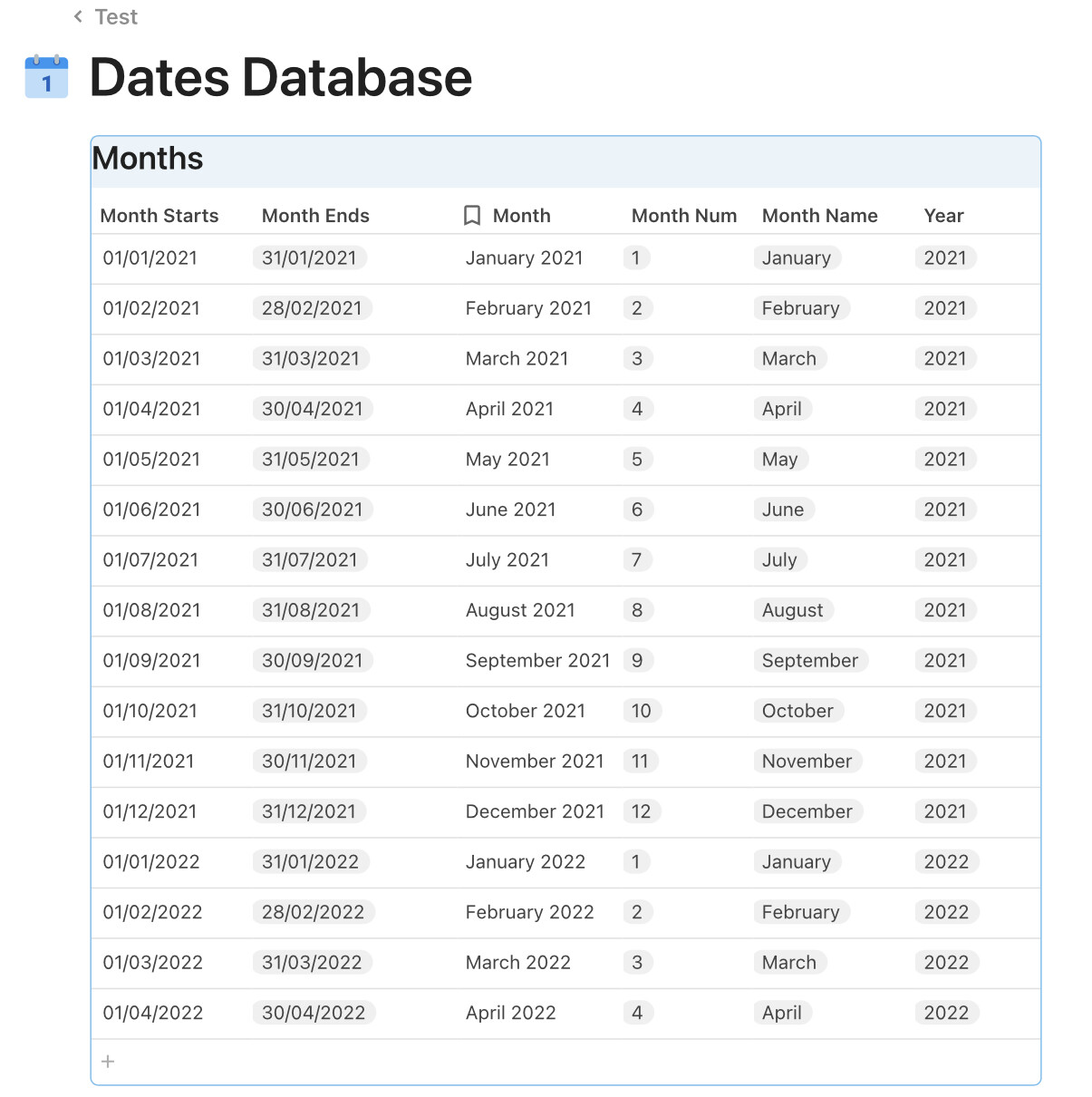

- end date (calculated based on starting date and duration)
- Workload (predefined - pourcentage - task attribute)
What I would like to achieve is to be able to get the utilisation of a resource at any chosen date for all the tasks (additional filters might be added like company, project, etc).
Is it something achievable?
Thank you in advance again for your assistance,
Johan
